How Long Does a Kitchen Remodel Take in Atkinson, NH?

June 12, 202610 min read

If you're planning a kitchen remodel Atkinson NH homeowners commonly describe as their biggest home project, the first question is almost always: "How long is this going to take?" As a kitchen remodeling contractor serving Atkinson NH since 1995, Sean Ryan & Son Carpentry has guided hundreds of Rockingham County homeowners through every phase of the process. Whether it's a kitchen remodel Rockingham County NH project in Salem, Kingston, or Hampstead—or right in Atkinson—the honest answer is that a full kitchen remodel runs anywhere from 8 to 20 weeks from first consultation to final walkthrough, depending on project scope, permit timing, and material lead times.

By Sean Ryan, Owner & Founder, Sean Ryan & Son Carpentry · Last updated June 2026

The Kitchen Remodel Timeline Guide: Step by Step

Most homeowners in Atkinson and the surrounding towns of Salem, Plaistow, Kingston, and Hampstead are surprised to learn that the construction phase—the part where saws are running and cabinets are going in—is rarely the longest part of the project. The weeks before a single nail is driven are where most of the timeline lives. Here's a step-by-step breakdown of what to expect.

Phase 1 — Initial Consultation and Design (Weeks 1–3)

Every kitchen remodel we complete in Rockingham County starts with a free, on-site estimate. During that first visit we assess the existing layout, discuss structural options, and identify anything that might complicate the project—outdated wiring, galvanized plumbing, load-bearing walls that need to be opened up. Homes built in the 1970s and 1980s, which make up a large share of the housing stock in Atkinson, Hampstead, and Windham, frequently have aluminum branch-circuit wiring or undersized electrical panels that need to be addressed before a remodel begins. Catching these during the design phase prevents costly surprises mid-build.

This phase typically runs two to three weeks, depending on how quickly decisions are made on layout, finishes, and cabinetry style.

What happens during Phase 1:

  • On-site measurement and assessment

  • Layout and design review (open plan vs. keeping existing footprint)

  • Cabinet, countertop, appliance, and fixture selections

  • Formal written estimate with itemized scope

Phase 2 — Permitting and Material Ordering (Weeks 3–6)

In Atkinson, kitchen remodels that involve structural changes, electrical upgrades, or plumbing modifications require a building permit from the Town of Atkinson Building and Code Enforcement office. We pull those permits as part of our full-service general contracting scope—homeowners don't have to navigate that process alone. Permit approval in Atkinson typically takes one to two weeks for standard residential remodel applications.

Under New Hampshire RSA 310-A, any contractor performing home improvement work in NH must hold a valid Home Improvement Contractor (HIC) registration, and the electrical and plumbing subcontractors we use hold the required NH trade licenses. We're happy to provide our documentation on request.

While permits are being processed, we submit orders for custom cabinetry, countertop materials, and any specialty fixtures. Custom cabinet lead times are one of the most common sources of schedule slippage on kitchen projects—semi-custom lead times run three to five weeks, and fully custom millwork can run six to eight weeks. Ordering early is the single biggest thing you can do to protect your kitchen remodel timeline.

What can delay Phase 2:

  • Custom cabinet lead times (3–8 weeks depending on manufacturer)

  • Natural stone countertop fabrication after templating (1–2 weeks post-cabinet install)

  • Permit processing time (typically 1–2 weeks in Atkinson)

  • Structural engineering if load-bearing walls are being opened

Phase 3 — Demolition and Rough Work (Weeks 6–8)

Once permits are in hand and materials are confirmed, we schedule demolition. This phase moves fast—a typical Atkinson kitchen demo runs one to two days. We protect adjacent living areas with dust barriers, remove old cabinets and appliances, and strip the space back to studs as needed. If the project involves opening a wall between the kitchen and dining room (a popular request in the colonial-style homes common throughout Rockingham County), framing work begins here.

Rough electrical and plumbing follow immediately after demo. If we're moving the sink, adding an island with a prep sink, or upgrading to a 240V range, the licensed trades sub-contractors work in sequence. Inspections at rough stage are typically scheduled within a week of completion in Atkinson.

Typical Phase 3 duration: 1–2 weeks

Phase 4 — Cabinet Installation and Countertop Templating (Weeks 8–11)

Cabinet installation is one of the most satisfying phases of a kitchen remodel because the space starts to take real shape. For a standard 150–200 square foot Atkinson kitchen, installation typically runs three to five days. Level, plumb, and square—on older homes this takes extra time because settling and seasonal movement mean floors and walls are rarely perfectly true.

Countertop templating happens after cabinets are fully installed. This is a firm sequencing requirement: the fabricator cannot template until every cabinet is in its final position. Natural stone slabs—granite, quartzite, and quartz composites are all popular choices among Rockingham County homeowners—then go to the fabricator for cutting. Fabrication and return delivery typically takes two weeks.

What affects Phase 4 timing:

  • Cabinet run length and complexity (corner solutions, pantry towers)

  • Material selection (stock quartz installs faster than custom-cut natural stone)

  • Kitchen layout (islands add time; L-shapes install faster than U-shapes)

Phase 5 — Final Installations and Finishing (Weeks 11–15)

With countertops in, the final phase moves quickly. Backsplash tile, appliance connections, plumbing trim-out (sink, disposal, dishwasher), light fixtures, hardware, and finish painting all happen in sequence. Flooring—if it's part of the scope—is typically installed after cabinet bases but before appliances roll in.

Final electrical inspection is scheduled through the town once all devices and fixtures are connected. Plumbing inspection follows sign-off on all supply and drain connections. These inspections in Atkinson and across Rockingham County are generally scheduled within a few days of request and rarely take more than a couple of days to pass.

Typical Phase 5 duration: 2–4 weeks

Phase 6 — Punch List and Final Walkthrough (Week 15–17+)

Before we call a project complete, we walk the entire kitchen with the homeowner—checking cabinet alignment, door swings, hardware, caulk lines, paint touch-ups, and appliance operation. As one of our Atkinson clients, Kevin G., put it: "You always know where you stand in the projects. His estimates are accurate. Easy to work with." That's exactly how we run every final walkthrough—nothing is signed off until you're satisfied.

Kitchen remodel in progress in Atkinson, NH—cabinet installation by Sean Ryan & Son Carpentry.

Kitchen Remodel Timeline by Project Size

Here's a practical reference for how timelines scale with project scope, based on our experience working in Atkinson, Salem, Kingston, and Hampstead:

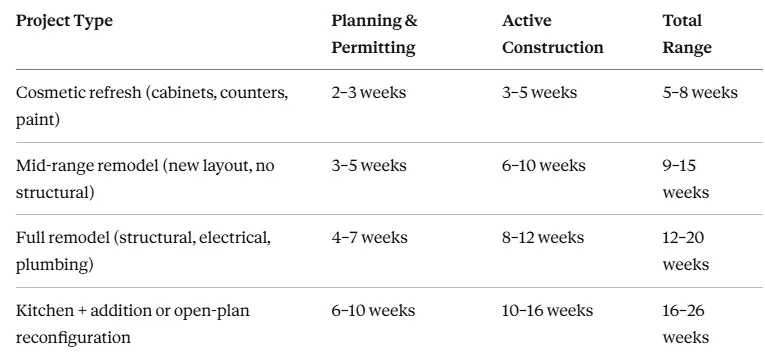

Kitchen Remodel Timeline by Project Size

What Delays a Kitchen Remodel in Rockingham County?

In 30 years of remodeling kitchens across Rockingham County, the same culprits come up repeatedly:

Late material decisions. Homeowners who finalize cabinet selections in week one start construction on time. Those who change their minds in week four push the entire schedule out. We front-load all finish decisions before demo day for exactly this reason.

Unexpected conditions behind walls. Older homes in Atkinson and Kingston frequently surprise us with knob-and-tube remnants, cast-iron drain lines that need upsizing, or inadequate insulation in exterior walls. We factor a contingency buffer into every estimate.

Custom lead times during peak season. NH contractors book up quickly in the spring-to-fall window. If you're planning a kitchen remodel in Rockingham County, reaching out in late winter gives you the best shot at a midsummer start. Our schedule fills faster than most people expect, as Doug C. notes: "Sean is a true professional whom you can trust. He is extremely knowledgeable and communicates very well."

Permit inspection scheduling. Atkinson and most Rockingham County towns schedule inspections within a few business days, but projects that require multiple inspection phases (rough, insulation, final) need those stages built into the schedule.

How Long Does a Kitchen Remodel Take? The Direct Answer

For Atkinson, NH homeowners planning a standard mid-range kitchen remodel: expect approximately 12–16 weeks from signed contract to final walkthrough, including the planning, permitting, and construction phases. A cosmetic refresh with no structural changes can wrap in 6–8 weeks. A full gut-and-reconfigure with load-bearing wall work and high-end custom cabinetry will run 16–20 weeks or more.

The kitchen remodel timeline guide step by step described above holds across most of Rockingham County. What varies by town is permit processing speed and inspection scheduling—and having a local contractor who knows the Atkinson building department makes that part of the process move smoothly.

Areas We Serve in Rockingham County

Sean Ryan & Son Carpentry performs kitchen remodels across Rockingham County NH, including Atkinson, Salem, Plaistow, Kingston, Hampstead, Windham, Danville, Sandown, Newton, and East Londonderry. If you're in southern Rockingham County and searching for a kitchen remodeling contractor Atkinson NH homeowners have trusted for three decades, we'd be glad to start with a free estimate.

Request a free kitchen remodel estimate

Kitchen remodel in progress in Atkinson, NH—cabinet installation by Sean Ryan & Son Carpentry.

Frequently Asked Questions: Kitchen Remodel Timeline in Atkinson, NH

1. How long does a kitchen remodel take in Atkinson, NH?

A full kitchen remodel in Atkinson, NH typically takes 12 to 16 weeks from signed contract to final walkthrough. That includes two to four weeks for design and permitting, one to two weeks for demolition and rough work, three to six weeks for cabinet and countertop installation, and two to four weeks for final installations and punch list. Cosmetic refreshes without structural changes can wrap in six to eight weeks. Projects involving load-bearing wall removal, custom cabinetry, or major plumbing reroutes may run 20 weeks or longer.

2. Do I need a building permit for a kitchen remodel in Atkinson, NH?

Yes. The Town of Atkinson requires building permits for kitchen remodels that involve structural changes, electrical upgrades, or plumbing modifications. Sean Ryan & Son Carpentry pulls all required permits as part of our full-service contracting scope. Permit applications are typically approved within one to two weeks for standard residential projects in Atkinson.

3. What is the biggest cause of kitchen remodel delays in Rockingham County?

Based on 30 years of completing kitchen remodels across Rockingham County NH, the single biggest cause of schedule delays is late or changing material selections—particularly cabinetry. Semi-custom cabinet orders have three-to-five-week lead times; fully custom millwork can take six to eight weeks. Homeowners who finalize all selections before demolition begins consistently experience the smoothest timelines.

4. When should I book a kitchen remodeling contractor in NH?

For a spring or summer start date, we recommend reaching out by late winter—January or February at the latest. Sean Ryan & Son Carpentry schedules fill several months in advance during the peak season. Off-season starts (October through February) often have faster availability and can be advantageous if you want to minimize the time your kitchen is out of commission during holidays.

5. Does a kitchen remodel increase home value in the Atkinson, NH area?

Yes, consistently. Kitchen remodels typically rank among the highest-ROI home improvement projects in southern New Hampshire. In the Rockingham County market—where well-maintained homes in towns like Atkinson, Hampstead, and Windham command strong prices—an updated kitchen with quality cabinetry, countertops, and efficient layout is a material selling point. Mid-range remodels in NH commonly recoup 60–80% of their cost at resale, with high-end finishes in move-up neighborhoods returning at the higher end of that range.

Visit or Call Us

Sean Ryan & Son Carpentry 1 Pheasant Lane Atkinson, NH 03811 Phone: (603) 362-8230 Text: (603) 300-6214 Email: [email protected] Hours: Call or text for current availability — free estimates offered

Serving Atkinson and surrounding Rockingham County communities including Salem, Plaistow, Kingston, Hampstead, Windham, Danville, Sandown, Newton, and East Londonderry, NH.

Custom HTML/CSS/JAVASCRIPT


Back to Blog
